Project Management

Design of Complex Integrated Circuits

12 Project Management

Project Management

  • Tapeout is irreversible. Once the layout database is sent to the foundry, no change is possible until silicon returns, typically after two to four months of fabrication, packaging, and shipping. A bug found afterward costs a re-spin, i.e., new masks (see Section 7.2) and another full fabrication cycle.

Project Management

  • Deadlines are fixed from the outside. Prototypes are often fabricated on a multi-project wafer (MPW) shuttle with a small number of fixed tapeout dates per year; missing a shuttle delays the project by months, not by days.
  • Verification dominates. A large and growing fraction of the effort is not spent on designing but on verifying the design. Nevertheless, industry surveys show that only a minority of IC/ASIC projects achieve first-silicon success, and that most projects are behind schedule (Foster 2024).

Why IC Projects Are Special

  • A project plan sets out how, who does what, and when
    • better: also quality level, cost, and resources
  • Tapeout is irreversible: a bug in silicon costs a re-spin (masks + months)
  • Fixed deadlines: MPW shuttles have only a few tapeout dates per year
  • Verification dominates the effort, still most projects are late and first-silicon success is rare
  • Planning makes risk visible early and leaves time and budget to handle it

12.1 Goals and Constraints

Goals and Constraints

  • Triple constraint: scope (incl. quality), time, cost—coupled, trade-offs must be explicit
  • SMART goals: specific, measurable, achievable, relevant, time-bound
    • bad: “design a low-power ADC”
    • good: “10 bit SAR ADC, ENOB ≥ 9.5 bit at 1 MS/s, ≤ 100 µW, on the March SG13G2 shuttle”
  • The specification is reviewed and frozen early
  • Later changes via a formal change request (impact on schedule and cost)

12.2 Project Phases

Project Phases

Table 15: Typical phases and milestones of an IC project
Phase Main activities Milestone (gate)
Definition Requirements, feasibility, technology choice, budget Specification and project plan frozen
Architecture System modeling, block partitioning, block specifications, test and debug concept Architecture review
Design Schematic/RTL design, block simulation and verification Design review
Layout Floor plan, block layout, P&R, top-level assembly, PEX simulation Layout review
Tapeout DRC/LVS/ERC sign-off, final verification, database release Tapeout
Fabrication Test PCB, test program, lab setup (in parallel to the fab run) Silicon arrival
Evaluation Functional test, characterization, debug Evaluation report
Qualification Reliability tests, production test release (products only) Release to production

The V-Model

  • Descending branch: decomposition (spec \(\rightarrow\) architecture \(\rightarrow\) blocks \(\rightarrow\) design and layout)
  • Ascending branch: verification and integration (blocks \(\rightarrow\) chip \(\rightarrow\) silicon)
  • Each level on the left defines the test criteria for the same level on the right
  • The tip of the V (tapeout, fabrication) cannot be iterated quickly
  • Every phase ends with a milestone = gate (review before the next phase)
  • Agile iterations work well for RTL and software—but must converge before tapeout

12.3 Statement of Work

Statement of Work

  1. Introduction/background
  2. Technical description
  3. Timeline and milestones
  4. Payment details
  5. Client expectations

12.4 Work Breakdown Structure

Work Breakdown Structure

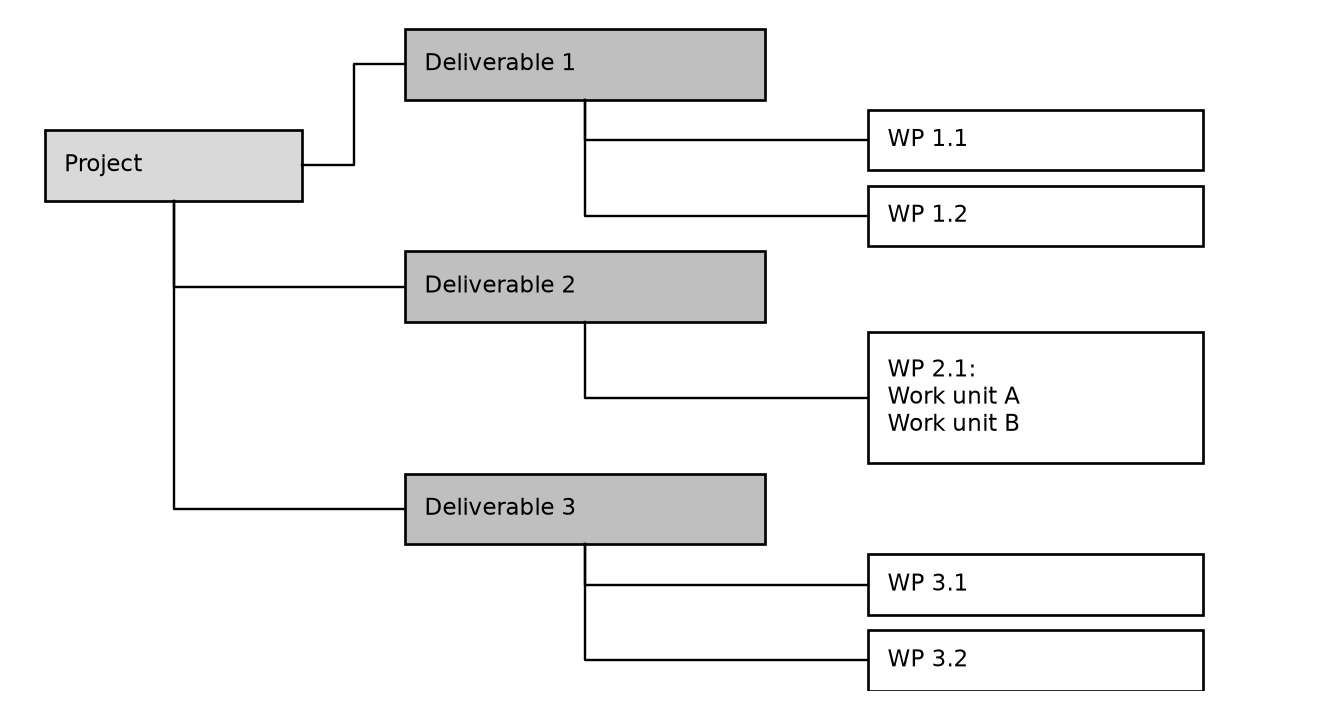

Figure 91: Work breakdown structure (WBS): the project is broken down into deliverables, each deliverable into work packages (WP), and each work package into work units.

Work Breakdown Structure

  • 100 % rule: the WBS contains the complete work of the project—no more and no less—and the children of each element add up to 100 % of the parent’s work. Work that does not appear in the WBS will not be planned, staffed, or budgeted.
  • Deliverable-oriented: the elements are outcomes (e.g., “bandgap reference, verified layout”), not activities or departments. This makes progress measurable.
  • Mutually exclusive: no work is contained in two elements, otherwise it is counted twice.

Work Breakdown Structure

  • Adequate granularity: a work package is small enough to be estimated and assigned to one responsible person, and large enough to be worth tracking; a common heuristic is a size between one day and a few weeks of effort.

Rules for a Good WBS

  • 100 % rule: complete work of the project, children add up to the parent
  • Deliverable-oriented: outcomes, not activities or departments
  • Mutually exclusive: no work counted twice
  • Granularity: estimable, one responsible person (≈ one day to a few weeks)
  • WBS dictionary: owner, content, inputs, deliverables, effort, completion criterion
  • Often forgotten in IC projects: top-level and mixed-signal verification, pad ring and ESD, package, test PCB and program, tapeout checks, documentation

12.5 Effort Estimation

Effort Estimation

\[ t_e = \frac{t_o + 4 t_m + t_p}{6}, \qquad \sigma_t = \frac{t_p - t_o}{6}. \tag{72}\]

Effort Estimation

  • Brooks’s law (Brooks, Jr. 1995): “Adding manpower to a late software project makes it later.” New team members need training by the experienced ones, and the communication overhead grows with the number of pairs, \(n(n-1)/2\), in a team of \(n\) persons. The same holds for IC projects.
  • Parkinson’s law: work expands to fill the time available. Generous buffers hidden in every task are consumed; it is better to estimate tasks realistically and to hold an explicit project buffer before the tapeout.

Effort Estimation

  • Verification effort is regularly underestimated. It is not a phase at the end, but runs in parallel to the design from the first block on (see Section 11 and Section 10.2).

Effort Estimation

  • Effort (person-days) \(\neq\) duration (calendar time); plan with 60–80 % availability
  • Three-point estimate (PERT): optimistic, most likely, pessimistic
  • Example: \(t_o = 5\), \(t_m = 8\), \(t_p = 17\) days \(\rightarrow\) \(t_e = 9\) days, \(\sigma_t = 2\) days
  • Use historical data and bottom-up estimates by the people doing the work
  • Brooks’s law: adding people to a late project makes it later (\(n(n-1)/2\) communication paths)
  • Parkinson’s law: hidden buffers get consumed \(\rightarrow\) explicit project buffer
  • Verification effort is regularly underestimated

12.6 Scheduling

Scheduling

  1. Task names
  2. Start/finish dates or durations of the tasks
  3. Dependency relationships between the tasks
  4. Lag relationships (start-to-start, finish-to-start, etc.)
  5. Task responsibilities (who does it)
  6. Required resources

Scheduling

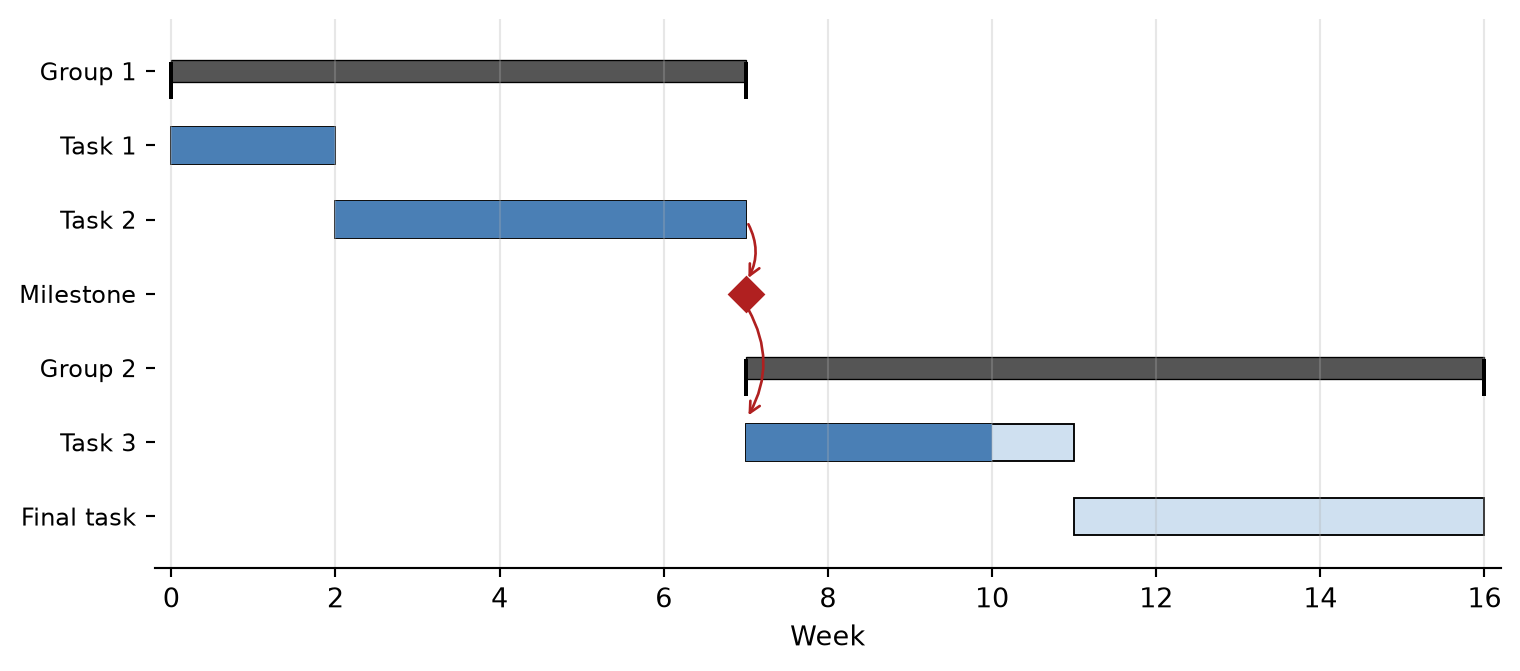

Figure 92: Exemplary Gantt chart of a 16-week project: bars show the task durations, dark fill the completed fraction, the diamond a milestone, and the arrows finish-to-start dependencies.

Scheduling

\[ \text{Float} = \text{LS} - \text{ES} = \text{LF} - \text{EF} \tag{73}\]

Scheduling

Table 16: Critical path analysis of a simplified mixed-signal chip project (durations in weeks)
Task Description Duration Predecessors ES EF LS LF Float
A Specification and architecture 2 – 0 2 0 2 0
B Analog design 6 A 2 8 2 8 0
C Digital RTL design and verification 4 A 2 6 6 10 4
D Analog layout 4 B 8 12 8 12 0
E Digital synthesis and P&R 2 C 6 8 10 12 4
F Top-level integration and verification 3 D, E 12 15 12 15 0
G Sign-off and tapeout 1 F 15 16 15 16 0

Critical Path Method

  • Forward pass: earliest start/finish (ES, EF = ES + duration)
  • Backward pass: latest finish/start (LF, LS = LF − duration)
  • Tasks with zero float form the critical path; delay there = delay of the tapeout
  • Example: analog design and layout are critical, digital branch has 4 weeks float
  • Backward scheduling from the shuttle date: negative float \(\rightarrow\) plan infeasible
  • The critical path can move; CPM assumes unlimited resources

12.7 Roles and Responsibilities

Roles and Responsibilities

Table 17: Example RACI matrix of a small IC project (R: responsible, A: accountable, C: consulted, I: informed)
Work package Project lead Analog designer Digital designer Layout Test engineer
Chip specification A R R C C
Bandgap reference I A/R – C C
Digital control (RTL) I C A/R – C
Top-level layout I C C A/R I
Tapeout sign-off A R R R I
Test program I C C – A/R

12.8 Risk Management

Risk Management

Table 18: Example risk register of an IC project (\(P\): probability, \(I\): impact, both rated 1 to 5)
Risk \(P\) \(I\) \(P \cdot I\) Response
Functional bug found after tapeout 3 5 15 Mitigate: verification plan with coverage metrics, reviews, spare cells and metal-fix options (see Section 10.5)
Late or immature PDK or IP 3 4 12 Mitigate: early test chip, qualified IP only, freeze PDK version
Key designer leaves or is unavailable 2 5 10 Mitigate: reviews, documentation, second person per critical block

Risk Management

Risk \(P\) \(I\) \(P \cdot I\) Response
Performance missed due to layout parasitics 3 3 9 Mitigate: parasitic estimates in early simulations, PEX simulations (see Section 10.3)
Shuttle date missed 2 4 8 Avoid: backward scheduling with buffer; accept: identify alternative shuttle
Specification change by customer 2 3 6 Mitigate: specification freeze and change-request process

Risk Management

  • Loop: identify, assess, plan response, monitor
  • Risk register: probability \(P\) × impact \(I\) \(\rightarrow\) priority
  • Responses: avoid, mitigate, transfer, accept (with contingency)
  • Biggest IC risk: non-functional first silicon
    • verification plan with coverage, independent reviews, tapeout checklist
    • test chips for new concepts, observability and programmability
    • schedule and budget contain a realistic metal re-spin

12.9 Reviews and Tapeout Checklist

Reviews and Tapeout Checklist

  • DRC, LVS, ERC, antenna, and density checks clean on the final database, all waivers documented and approved by the foundry (see Section 4.7)
  • Post-layout (PEX) simulations of all critical blocks over corners and temperature (see Section 10.2)
  • ESD and latch-up checks, pad ring and bonding diagram matched to the package (see Section 9 and Section 5)
  • Seal ring, chip ID/revision marking, alignment and test structures present

Reviews and Tapeout Checklist

  • Top-level netlist and layout versions tagged in the version control system; the final GDSII checksum recorded
  • Test concept and test PCB ready to start in parallel to the fabrication (see Section 6.4)

Design Reviews and Tapeout Checklist

  • Design reviews at every gate: cheapest way to find errors
    • documents in advance, independent reviewers, written action items (owner, due date)
    • “what if” questions: power-up, unsettled references, illegal states
  • Tapeout checklist (grows with every project):
    • DRC/LVS/ERC/antenna/density clean, waivers approved
    • PEX simulations over corners and temperature
    • ESD/latch-up, pad ring, bonding diagram
    • seal ring, chip ID, test structures
    • versions tagged, GDSII checksum recorded
    • test PCB and program started

12.10 Tracking and Control

Tracking and Control

\[ \text{SPI} = \frac{\text{EV}}{\text{PV}}, \qquad \text{CPI} = \frac{\text{EV}}{\text{AC}} \tag{74}\]

Tracking and Control

  • Weekly status: work packages, action items, top risks
  • Measure progress by completed deliverables, not by time spent
  • Earned value: SPI = EV/PV (schedule), CPI = EV/AC (cost)
    • example: PV = 40, EV = 32, AC = 45 person-weeks \(\rightarrow\) SPI = 0.8, CPI ≈ 0.71
  • Milestone trend analysis: rising line = slipping milestone (early warning)
  • Version control, issue tracker, automated regressions
  • Lessons learned update estimates and the tapeout checklist

12.11 Team and Communication

Team and Communication

  • Conway’s law: system structure mirrors the communication structure
    • block interfaces = team interfaces (analog, digital, layout, test) \(\rightarrow\) likely bugs
    • write down, own, and review interface specifications
  • Design work needs uninterrupted concentration; context switches are expensive
  • Protect the team, resolve blockers quickly, communicate bad news early
